Construction Permitting & Project Management in South Florida

What does construction permitting in South Florida involve?

Construction permitting South Florida is the work of getting a luxury home approved, built and inspected across Broward, Palm Beach and Miami-Dade, where every municipality interprets the Florida Building Code through its own review process. Kass Construction treats approvals as part of the critical path rather than paperwork that follows design.

In South Florida’s high-stakes luxury construction market, permitting and project management are the invisible forces that determine success or failure. While beautiful design and premium finishes capture attention, it is expert regulatory navigation and disciplined execution control that keep projects on schedule, on budget, and fully compliant with some of the nation’s most stringent building codes.

Planning a build that needs coastal, flood or municipal review? Kass Construction & Development, Florida Certified General Contractor CGC1529472, has delivered 100+ luxury residences across Broward, Palm Beach and Miami-Dade under Mitchell Kass and the firms he has led. Call 954-607-4335 or request a consultation.

At Kass Construction & Development, we treat permitting and project management as core competencies, not afterthoughts. Our integrated team of state-licensed general contractors, real estate attorneys, and licensed real estate professionals brings deep, municipality-specific expertise across Broward, Miami-Dade, and Palm Beach counties. This one-roof model eliminates the coordination gaps that commonly cause delays, cost overruns, and compliance issues in luxury custom homes, waterfront estates, and high-end renovations.

Why is construction permitting exceptionally complex in South Florida?

South Florida’s coastal environment and regulatory environment create unique challenges:

  • Hurricane Mitigation: Strict wind-load requirements, impact-resistant standards, and continuous load path engineering
  • Flood Zone Compliance: FEMA Base Flood Elevation (BFE) rules, VE/AE zones, and elevation certifications
  • Coastal Construction Codes: Seawall regulations, environmental protections, and marine construction standards
  • Municipal Variations: Each city (Fort Lauderdale, Boca Raton, Miami, etc.) maintains its own review processes, timelines, and interpretation of the Florida Building Code

These layers mean that incomplete or uncoordinated submissions frequently trigger multiple review cycles, adding months to project timelines.

How does the construction permitting process work, step by step?

Kass Construction & Development manages the entire South Florida permitting journey with precision and proactive coordination.

1. Pre-Submission Planning & Coordination

Before any plans are submitted, we ensure full alignment between the architect, structural engineer, MEP engineers, and our construction team. This includes:
  • Complete plan sets with all required disciplines
  • Early identification of potential code conflicts
  • Value engineering input to maintain feasibility

2. Plan Submission & Multi-Department Review

We submit to the appropriate municipal building department and coordinate reviews across:
  • Building, zoning, and planning departments
  • Engineering and flood review
  • Fire safety and environmental compliance

3. Comment Resolution & Resubmittals

Most projects receive comments requiring revisions. Kass’s experienced team responds quickly and accurately, minimizing review cycles and accelerating approvals.

4. Permit Issuance & Pre-Construction Mobilization

Once permits are issued, we finalize scheduling, secure trade partners, and prepare the site for groundbreaking with full regulatory documentation in place.

What inspections and ongoing compliance happen during construction?

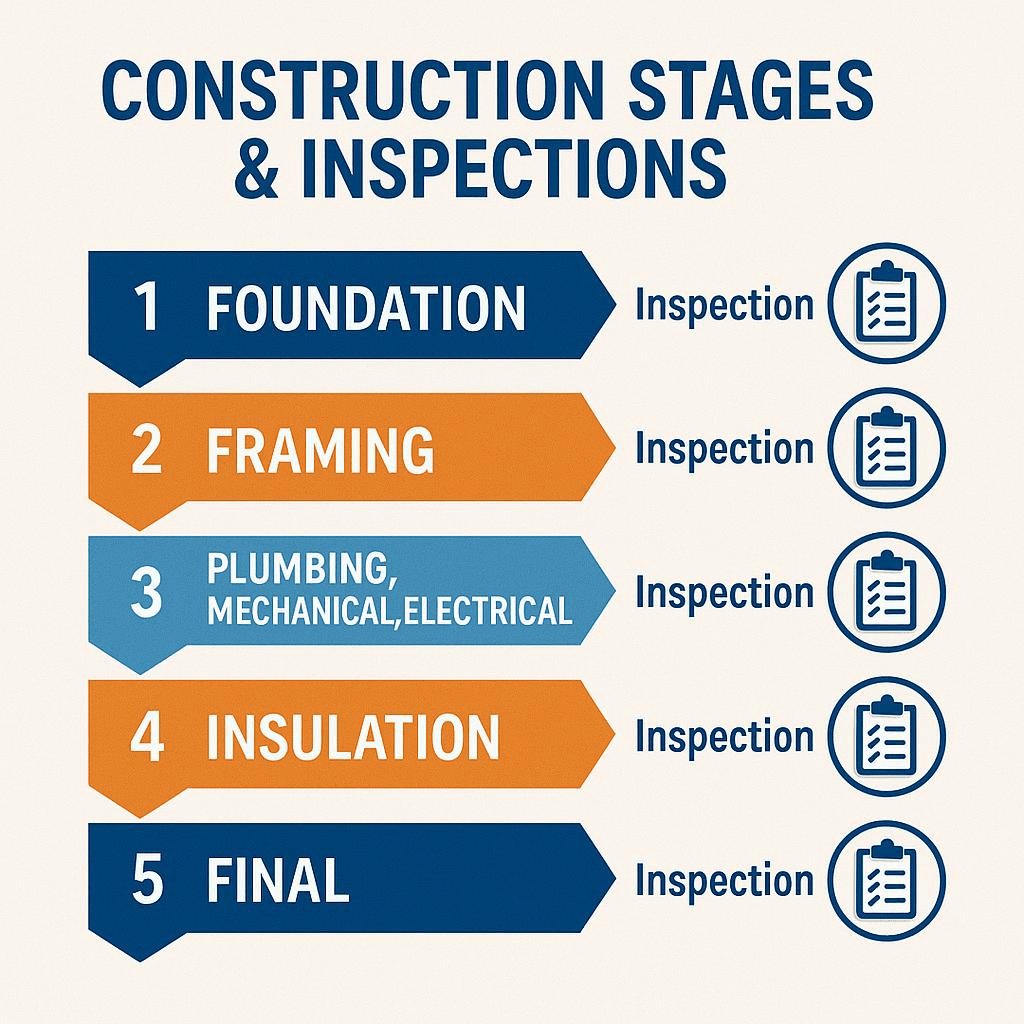

Permitting in South Florida does not end with approval. Throughout construction, projects must pass sequential inspections:
  • Foundation and slab
  • Structural framing and reinforcement
  • Rough mechanical, electrical, and plumbing (MEP)
  • Insulation, framing, and energy compliance
  • Final inspection and Certificate of Occupancy (CO)
Our on-site project managers and superintendent maintain meticulous records and coordinate inspectors to prevent stop-work orders or costly rework.

How does project management control time, cost, and quality?

  • Effective project management on a South Florida luxury home requires far more than basic scheduling. Kass delivers:
    • Master Scheduling: Detailed timelines with critical path management and built-in buffers for permitting variables
    • Budget Control & Cost Tracking: Real-time monitoring with transparent reporting to prevent drift
    • Trade Coordination & Sequencing: Orchestrating multiple specialty contractors with precision
    • Quality Assurance Protocols: Multi-stage inspections and documentation at every milestone
    • Risk Mitigation: Proactive identification and resolution of potential issues before they impact the project
    This disciplined approach is especially critical for waterfront properties and complex renovations where site constraints and regulatory overlays multiply the variables.

How do you avoid cost overruns and timeline delays?

The leading causes of problems in South Florida luxury construction include:
  • Incomplete or uncoordinated permit submissions
  • Mid-project design changes
  • Unanticipated code requirements or flood elevation issues
  • Poor trade sequencing and communication gaps
Kass mitigates these risks through early feasibility analysis, complete pre-construction documentation, and integrated legal oversight that anticipates regulatory and contractual exposures.

Why do experience and integration matter in South Florida permitting?

A builder with deep Broward, Palm Beach, and Miami-Dade knowledge understands how to:

  • Anticipate municipality-specific requirements
  • Build relationships with plan reviewers and inspectors
  • Coordinate complex plan sets that sail through review
  • Maintain momentum even when revisions are required

Our multi-disciplinary model, combining construction expertise with real estate legal and market intelligence, delivers smoother approvals, tighter schedules, and greater cost certainty.

Explore the fifteen Insights pillars

GMP vs cost-plus, AIA contracts, change orders, escrow, warranties, insurance, and disputes.

Seawall and dock permitting, repair vs replacement, corrosion-resistant materials, and resilience.

What an owner’s rep does, when to hire one, quality control, and managing your design team.

Remote project management, contracts, banking, taxes, and reporting for buyers abroad.

AE, VE, and X zones, base flood elevation, FEMA certificates, insurance, and elevation strategies.

Whole-home automation, security, lighting, energy management, and future-proof systems.

Sustainable materials, passive cooling, native landscaping, and wellness-oriented design.

County differences, CCCL and seawall permits, common delays, and faster approvals.

Zoning, permitting, flood rules, pricing, and market trends, county by county.

Cost to build, budgets, timelines, teardown vs renovation, and contingency planning.

Indoor-outdoor living, resilient waterfront estates, and choosing the right custom builder.

Neighborhood guides: Las Olas Isles, Harbor Beach, Coral Ridge, Rio Vista, Bay Colony, and more.

City guides: Fort Lauderdale, Boca Raton, Pompano Beach, Hillsboro Beach, Hollywood, and more.

Intracoastal, Atlantic oceanfront, New River, Middle River, Tarpon River, Stranahan River, and canals.

Whole-home renovation, modernizing older estates, structural reconfiguration, kitchen ROI, and spa bathrooms.

Frequently Asked Questions

How long does the permitting process take in South Florida? Timelines typically range from 2 to 6+ months depending on the municipality, project complexity, and completeness of the initial submission. Waterfront and high-design projects often require additional review cycles. Early coordination with Kass significantly reduces delays.
Incomplete plan sets, lack of coordination between disciplines, and failure to anticipate flood or hurricane code requirements. Kass’s pre-submission review process is designed to catch these issues before submission.
Yes. Most structural changes, systems upgrades, additions, and flood-related modifications must be permitted and inspected to current Florida Building Code standards.

Through detailed pre-construction planning, fixed-scope budgeting, proactive risk management, and continuous cost tracking. Our integrated team minimizes change orders and keeps the project aligned with approved budgets and timelines.

Related Guides: Construction Permitting & Project Management

Dive deeper into the permitting and project management process for luxury construction in South Florida with these in-depth guides:

Final Thought

Construction permitting and project management are the control systems that protect your investment in South Florida’s demanding luxury market. When handled by an experienced, integrated team, they transform potential roadblocks into predictable milestones, delivering your custom home, waterfront estate, or luxury renovation on time, on budget, and fully compliant.
If you are planning a new build, waterfront project, or high-end renovation and want expert guidance through the regulatory and execution challenges, contact Kass Construction & Development for a strategic consultation.

Kass Construction & Development

East Fort Lauderdale, Florida
Serving Broward • Palm Beach • Miami-Dade

Permitting Mastery. Project Discipline. Predictable Excellence.

Permitting and Project Management: Common Questions

What actually drives a permitting timeline?

Four things: which municipality reviews the drawings, whether the parcel triggers coastal or environmental review, how complete the submission is on day one, and how quickly comments are resolved. Scope and square footage matter far less than owners expect.

The same drawing set can move at very different speeds two towns apart. Some building departments run concurrent departmental review; others route a submission through zoning, structural, mechanical, electrical, plumbing and fire in sequence, so a single comment from the last reviewer can restart a cycle. Knowing which model applies before design is finished is what separates a predictable program from an open-ended one.

Completeness is the single biggest controllable factor. A submission missing an elevation certificate, a product-approval schedule or a signed and sealed structural calculation will sit in the queue while it is corrected, and the clock does not stop. On waterfront parcels the same is true of survey detail: if the seawall, dock or submerged-land boundary is not clearly documented, the reviewer cannot approve what they cannot see.

Which reviews sit outside the building department?

Anything touching water, elevation or the coastline. Seawalls, docks and work over submerged land bring in authorities beyond the city, and oceanfront parcels can trigger additional state review. These run in sequence with the building permit, not in parallel, so they belong on the schedule from day one.

Owners are often surprised that a project can hold a building permit and still be unable to start, because a separate approval has not issued. The practical consequence is that a waterfront program has to be built backwards from the longest approval, not forwards from the design completion date. See flood-zone requirements in Broward County and waterfront home construction.

How does Miami-Dade differ from Broward and Palm Beach?

Miami-Dade applies its own product-approval regime for windows, doors and roofing on top of the state code. That pushes specification decisions much earlier, because a product that is acceptable in one county may not carry the required approval in another.

This is a design-stage decision disguised as a procurement decision. Selecting glazing late, or substituting a product during construction because of lead times, can require a revision to an already-approved permit. Our guide to hurricane-resistant construction covers what the wind zone dictates.

What does a revision cost in time?

More than owners assume. A permit revision re-enters review, and depending on the department it can take as long as portions of the original approval. Changes decided during construction are therefore rarely cheap, even when the construction cost of the change itself is small.

This is why change-order language written before construction matters so much. The cost of a change is the material and labor plus the schedule consequence, and on a permitted project the schedule consequence is usually the larger number. See construction contracts and where cost overruns come from.

What does project management cover once the permit issues?

Inspection sequencing, subcontractor coordination, submittal and shop-drawing review, and cost and schedule control against the contract. The permit is the beginning of the controlled phase, not the end of the difficult one.

Inspections have to be called in the right order and passed before covering work; a failed or missed inspection can mean opening finished work. Long-lead procurement has to be tracked against the construction sequence rather than the calendar, because a delivery that arrives after its installation window has passed pushes every trade behind it.

Can permitting begin before the design is finished?

Parts of it can, and often should. Site feasibility, zoning confirmation and elevation determination do not require a complete drawing set, and resolving them early prevents a design that has to be redrawn once the constraints are known.

Bringing a builder into the process during design rather than after it is the single change that most reliably shortens a program, because constructability, cost and permitting feedback arrive while revisions are still inexpensive. See pre-construction planning.

Who is responsible if a permit lapses?

Practically, the party managing the project. Permits carry activity requirements, and a job that goes quiet can require reinstatement or resubmission. Keeping inspections current is part of construction management, not an administrative afterthought.

How long does the whole process take?

It varies too much by municipality and parcel for a single figure to be honest. What is consistent is that a high-end renovation often runs 6 to 12 months on site and a ground-up custom build often runs 18 to 36 months, and coastal or flood review can extend the approval stage within those ranges.

We would rather give a wide honest range early than a narrow one that fails. See how long it takes to build a custom luxury home in South Florida, or start a conversation about a specific parcel.

What documents should an owner expect to see?

The approved permit set, the elevation certificate where the flood zone requires one, product-approval documentation for windows, doors and roofing, the inspection record as it is built, and the closeout package at completion. If a builder cannot produce these on request, that is worth noticing early.

Documentation is not bureaucracy on a permitted project; it is the only way an owner can test a claim rather than accept it. When a change order arrives, the approved set is what the price is measured against. When a concealed detail is questioned months later, the inspection record is what settles it. This is the same reason construction permitting and project management in South Florida is treated here as one discipline rather than two departments.

What happens at closeout?

Final inspections are called, any open comments are cleared, and the certificate of occupancy or completion issues. Until that happens the project is not finished in the eyes of the municipality, regardless of how complete it looks.

Closeout is where poorly managed projects lose weeks. Open permits from subcontracted trades, a missed inspection on work that has since been covered, or a lapsed sub-permit can all hold a certificate. Tracking every permit opened on a job, including those pulled by trades, is part of the management scope from the first day rather than something assembled at the end.

Does this change for a renovation?

Yes, and the decisive question is scope. Once a renovation crosses the substantial-improvement threshold, the whole structure may have to be brought into current code compliance rather than only the renovated portion, which changes both the permitting path and the budget.

That threshold is assessed against the property, so confirm it with the municipality before the scope is fixed. Where the answer pushes a project past the line, rebuilding is sometimes the more economical route. See whole-home luxury renovation and teardown versus renovation.

Who should own the permitting relationship?

One accountable party. When permitting sits with a builder, the architect and a separate expediter without a single owner, comments fall between them and the owner becomes the messenger. A single point of responsibility with one documentation standard removes that failure mode.
