How Long Does It Take to Build a Custom Luxury Home?

How long it takes to build a custom luxury home in South Florida is a question with an honest answer and a useful one, and they are different. The honest answer is that a custom build often runs 18 to 36 months. The useful answer is what decides where a particular project lands in that range, because almost every variable is known before anyone breaks ground.

Key takeaways

  • How long does it take to build a custom luxury home?
    In South Florida it often takes 18 to 36 months to build a custom luxury home, and often 6 to 12 months for a high-end renovation.
  • What happens before construction starts?
    Before construction starts on a South Florida lot: site underwriting, program definition, schematic and design development, construction documents, specification, budgeting, and the opening of every agency review.
  • Why does permitting take so long here?
    Because South Florida applies demanding wind, flood, and coastal requirements through several agencies that review independently.
  • Which construction phases take the longest?
    The longest phases are foundations and structure on a South Florida coastal site, because deep foundations and elevated structure take real time; the envelope, because impact glazing and roofing are both long-lead and weather-dependent; and interior finishing, because it is the phase with the most trades, the most sequencing, and the most owner decisions.
Time required to build a custom luxury home in South Florida
Construction is rarely the variable. Approvals, procurement, and decisions are.

How long does it take to build a custom luxury home?

In South Florida it often takes 18 to 36 months to build a custom luxury home, and often 6 to 12 months for a high-end renovation. Where a project falls depends on the parcel, the approvals required, the complexity of the structure, procurement lead times, and how many decisions were closed before mobilizing. The construction itself is rarely the variable.

To build a custom luxury home on schedule, the phase-by-phase breakdown in a realistic timeline for luxury custom home construction.

What happens before construction starts?

Before construction starts on a South Florida lot: site underwriting, program definition, schematic and design development, construction documents, specification, budgeting, and the opening of every agency review. On many projects this front half is as long as the construction half, and it is entirely invisible from the street, which is why owners underestimate it so consistently.

Owners who build a custom luxury home smoothly finish this phase properly, as described in pre-construction planning.

Why does permitting take so long here?

Because South Florida applies demanding wind, flood, and coastal requirements through several agencies that review independently. Municipal building and zoning, county floodplain, state environmental and coastal programs, and federal reviewers for work in navigable waters all run their own calendars, and the slowest one governs the start date.

Approvals set the start date when you build a custom luxury home here; the map is in the South Florida luxury home permitting process, with code at the Florida Building Code.

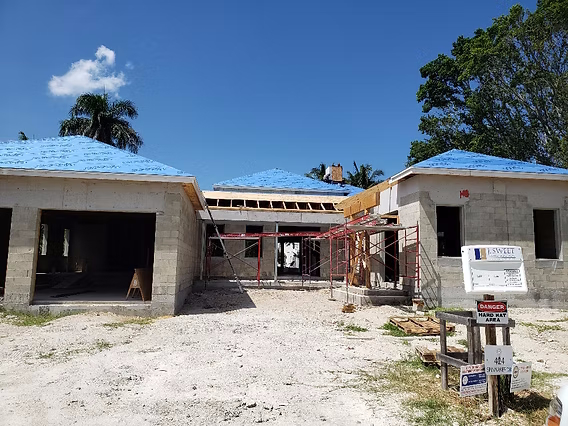

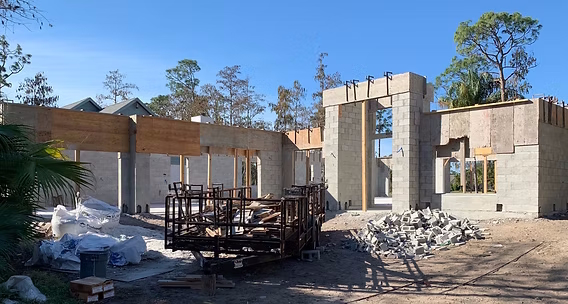

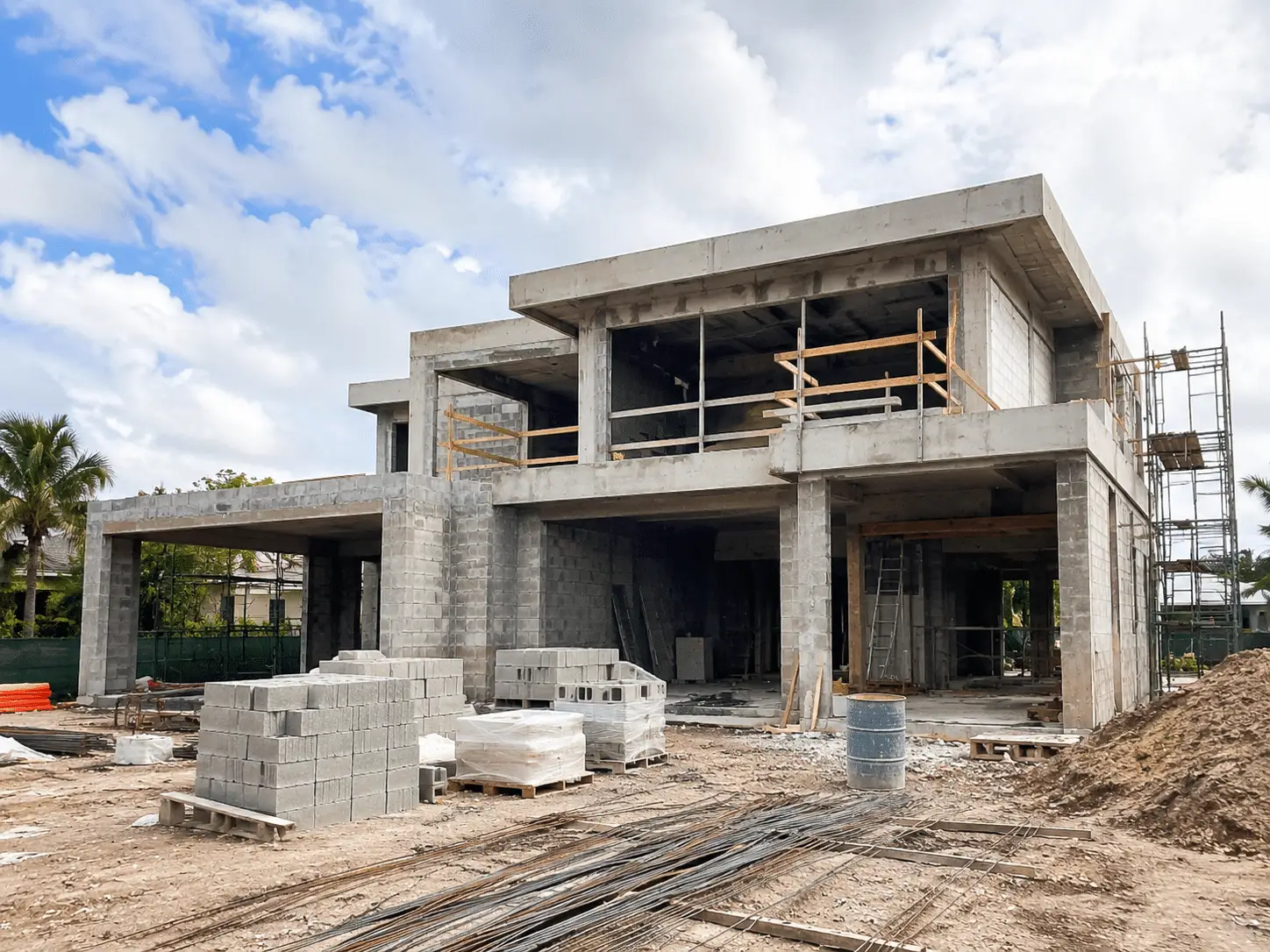

Structure going up on a project to build a custom luxury home
Foundations and structure on a coastal site take real time and cannot be compressed safely.

Which construction phases take the longest?

The longest phases are foundations and structure on a South Florida coastal site, because deep foundations and elevated structure take real time; the envelope, because impact glazing and roofing are both long-lead and weather-dependent; and interior finishing, because it is the phase with the most trades, the most sequencing, and the most owner decisions. Rough-in is usually faster than owners expect.

These phases are what it takes to build a custom luxury home to coastal standards, set out in hurricane-resistant construction.

What decides how long it takes to build a custom luxury home
Factor Effect on the schedule When it is fixed
Parcel and flood zone Sets foundation and elevation work Before purchase
Agency review Frequently sets the start date Opened during design
Specification completeness Decides how much is decided later Before pricing
Long-lead procurement Sets dates nothing else can move Early construction
Owner decision speed The most common cause of slippage Throughout
Waterfront scope Adds seawall, dock, and marine review Before mobilization

What is the single biggest schedule risk?

The single biggest schedule risk on a South Florida custom home is open decisions. A selection that has not been made cannot be ordered, and an item that has not been ordered cannot arrive. Nearly every schedule that slips on a project to build a custom luxury home slips because a decision waited, not because a crew was slow. Front-loading selections is the highest-value schedule protection available.

Procurement discipline is covered in contingency planning for supply chain issues.

How do long-lead items affect the program?

Long-lead items set dates that nothing else on a South Florida build can move. Impact-rated windows and doors, custom millwork, imported stone, specialty appliances, elevators, and generators all carry lead times measured in months, and several must be ordered before the work that receives them begins. The schedule is built backwards from these.

Anyone planning to build a custom luxury home orders these first; material considerations are in coastal corrosion-resistant materials.

Does waterfront add time?

Waterfront in Broward, Palm Beach, or Miami-Dade does add time, and mostly at the front. Seawall assessment or replacement, dock and lift approvals, environmental review, and coastal jurisdiction on oceanfront parcels all run before or alongside the residence. Marine work sequenced late is the classic waterfront delay, because equipment access becomes much harder once a house is standing.

To build a custom luxury home on the water, the shoreline comes first, as set out in seawall construction and permitting.

What can an owner actually do to compress the schedule?

A South Florida owner can compress the schedule with five things: underwrite the parcel before buying, close the specification before pricing, make selections early, open the slowest approvals first, and respond to questions inside an agreed turnaround. None of these speed up construction; all of them remove the waiting that surrounds it.

These five are the owner’s real levers when they build a custom luxury home; the remote version is in building as an absentee international owner.

What does a slipped schedule cost?

A slipped schedule on a South Florida luxury build costs more than patience. General conditions, supervision, insurance, temporary services, financing, and land carrying cost all accrue monthly regardless of progress. Time is a budget line on any project to build a custom luxury home, which is why schedule protection is also cost protection.

The budget link is in how to budget a luxury home build.

How does Kass Construction & Development manage the schedule?

By building it backwards from lead times and approvals: Kass Construction & Development, a state-licensed (CGC1529472) boutique luxury builder led by Mitch Kass, a licensed general contractor and attorney, with 100+ luxury residences delivered by Mitchell Kass and the firms he has led across Broward, Palm Beach, and Miami-Dade, sequences the slowest agency review and the longest-lead material first so the rest of the work has somewhere to go.

Contact Kass Construction & Development or call 954-607-4335.

What does a phase-by-phase schedule look like for a custom luxury home in South Florida?

The custom home building process in Florida runs as a chain of dependent phases, and the total only makes sense when each link is shown with its own realistic range.

Phase Typical range What has to be finished before the next phase can start
Feasibility, survey, soils and zoning confirmation 1 to 2 months Boundary and elevation survey, geotechnical report, confirmed setbacks and height
Schematic and design development 3 to 5 months Owner sign-off on plan, massing, and the outline specification
Construction documents and engineering 3 to 4 months Coordinated architectural, structural, MEP and civil sets; product approvals matched
Permitting and agency review 3 to 6 months, overlapping construction documents Building, zoning, floodplain, and any environmental or coastal approvals issued

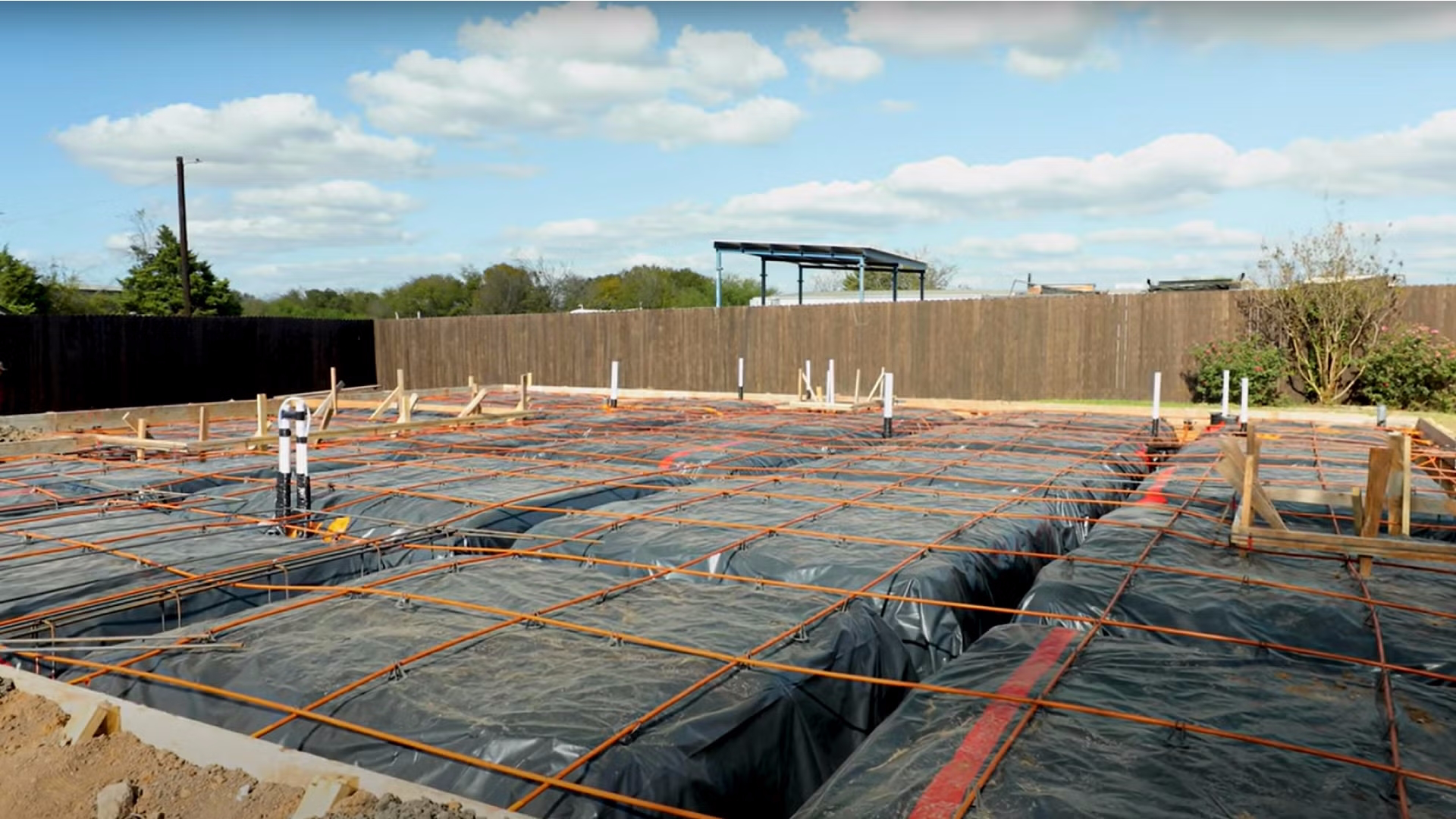

Site work, foundation and shell 4 to 7 months Piles or footings, slab, masonry, structural steel and roof deck inspected
Dry-in, rough-ins and inspections 3 to 5 months Windows and doors installed, roofing complete, rough MEP passed
Finishes, millwork and systems commissioning 4 to 7 months All selections on site, punch list closed, systems tested
Final inspections and certificate of occupancy 1 to 2 months Every open permit inspected and closed

Design and permitting alone can consume 7 to 13 months before the first pile is driven, which is why an owner who expects to build a custom luxury home in a year is usually measuring only the construction half. The wider view of the phases is in our realistic timeline for luxury custom home construction and in the pre-construction planning guide.

Which approvals run on their own calendars?

The custom home building process in Florida is slowed less by any single reviewer than by reviews that cannot be started until another one finishes.

  • Municipal zoning and building review under the Florida Building Code, with separate structural, mechanical, electrical, plumbing and fire disciplines commenting on the same set.
  • Floodplain review against the design flood elevation on the FEMA map, including any local freeboard requirement above base flood elevation; see our guide to FEMA elevation certificates.
  • Seawall, dock and submerged-land work reviewed by the county environmental agency and, for some parcels, the Florida Department of Environmental Protection. Details are in seawall construction and permitting in South Florida.
  • Coastal Construction Control Line review for oceanfront lots, which is a state process with its own submittal standard.
  • Utility, right-of-way, and driveway approvals that are small on their own but block the certificate of occupancy if forgotten.

The differences between the three counties are covered in permitting differences across Broward, Miami-Dade and Palm Beach, and the mistakes that add months are in common luxury home permitting mistakes.

Which long-lead items should be ordered before the slab is poured?

To build a custom luxury home on schedule, the items with the longest factory lead times have to be released while the foundation is still in the ground.

  1. Impact-rated window and door packages, which carry the longest and least flexible lead times of any component on a coastal home.
  2. Structural steel, custom trusses, and any engineered beams that are fabricated to the approved drawings.
  3. Elevators, generators, and switchgear, which are built to order and require rough-in dimensions early.
  4. Stone slabs, large-format tile, and imported flooring that must be reserved from a specific lot.
  5. Custom millwork, kitchen cabinetry, and specialty metalwork that need shop drawings approved months before installation.
  6. Roofing systems with specific product approvals, particularly standing-seam metal and clay tile in special colors.

Supply disruption is a schedule risk in its own right; our note on contingency planning for supply chain issues shows how allowances and alternates are built into the program. Material choices that survive salt air are covered in coastal corrosion-resistant materials.

How does the schedule tie to payments and to the contract?

A well-drafted contract for a custom luxury home in South Florida makes the schedule a measured thing rather than a promise.

  • Milestones are defined by inspected work, not by calendar dates, so a draw is released when the roof deck passes, not on the first of the month; see payment schedules, contingency and budgeting.
  • The baseline schedule is an exhibit to the agreement, and any change order states its schedule impact in days alongside its price.
  • Weather days are defined; Florida law allows a contractor to be paid on a lawful schedule and gives owners defined remedies under Chapter 489, Florida Statutes.
  • Owners who cannot be on site keep control through reporting cadence, which we describe in building as an absentee or international owner.

The contract structures that make this enforceable are compared in construction contracts for high-end residential builds.

Frequently Asked Questions

How long does it take to build a custom luxury home in South Florida?

Often 18 to 36 months for a custom build and 6 to 12 months for a high-end renovation. Where a project lands depends on the parcel, approvals, structural complexity, lead times, and how many decisions were closed early.

How much of that is construction?

Frequently only half. Design, documentation, specification, and multi-agency approvals occupy the front of the program and are invisible from the street.

Why does permitting take so long?

Because several agencies review independently against demanding wind, flood, and coastal requirements, and the slowest review governs the start.

What delays projects most often?

Open decisions. An unmade selection cannot be ordered, and an unordered item cannot arrive. Front-loading selections is the strongest protection available.

Which items have the longest lead times?

Impact-rated windows and doors, custom millwork, imported stone, specialty appliances, elevators, and generators. The schedule is built backwards from these.

Does building on the water take longer?

Yes, mostly at the front: seawall, dock, environmental, and coastal reviews run before or alongside the residence, and marine work sequenced late becomes much harder.

Does a longer schedule cost more?

Yes. General conditions, supervision, insurance, financing, and carrying costs accrue monthly, so protecting the schedule protects the budget.

What is the longest part of the process?

Permitting is often the most time-consuming phase.

Can a luxury home be built in under a year?

Rarely—only in highly simplified or pre-approved scenarios.

What causes construction delays?

Permits, design changes, material delays, and weather.

Schedule a Consultation

If you are planning a luxury home or high-end renovation in South Florida, Kass Construction & Development provides expert guidance from day one.

Related Posts

How builders and architects collaborate on a luxury custom home

How Builders and Architects Collaborate on Custom Homes

How builders and architects collaborate on luxury custom homes: when the builder joins, what each contributes, and how changes and disputes are handled.

Luxury waterfront home at sunset with glass windows, private dock, seawall, tropical landscaping, and palm trees reflecting on calm water.

Palm Beach County Waterfront Luxury Construction Guide for Owners

The full arc of waterfront luxury construction in Palm Beach County: underwriting the lot, designing for water and wind, sequencing permits, planning the marine scope, and building the right team.

Scroll to Top
