Waterfront home construction South Florida buyers imagine usually begins with the view. The projects that go well begin somewhere less romantic: the seawall, the flood map, the water depth, and the list of agencies that will review the work. This guide walks the decisions in the order they actually matter, from evaluating a lot through structure, approvals, cost, and schedule, so an owner arrives at the design conversation already knowing what the site will allow.
Key takeaways
- Why is building on the water fundamentally different?
Building on the South Florida water is different because three systems must succeed together: the shoreline holding the land in place, the structure standing above flood and wind loads, and the approvals stack clearing on time. - What has to be verified before the lot is purchased?
Verify six items before buying a South Florida waterfront lot: the seawall's age, cap condition, and tie-backs; the flood zone and base flood elevation; dock rights, permitted structures, and water depth at mean low tide; bridge clearance to open water; exposure, wake traffic, and orientation; and whether the parcel sits seaward of the Coastal Construction Control Line. - What does the structure require?
The structure of a South Florida waterfront home requires deep foundations matched to coastal soils and scour; a lowest floor elevated above base flood elevation plus local freeboard; a continuous load path with corrosion-protected connectors; impact-rated openings engineered for the site's true pressures; and flood-damage-resistant materials anywhere below the flood line. - How should the shoreline and marine scope be handled?
Handle the shoreline and marine scope first, and as its own subproject: seawall condition decides whether the wall is repaired, capped, or replaced before the house begins; dock and lift design must match vessel, depth, and navigation rules; and both run through reviewers independent of the building department.
Why is building on the water fundamentally different?
Building on the South Florida water is different because three systems must succeed together: the shoreline holding the land in place, the structure standing above flood and wind loads, and the approvals stack clearing on time. Inland, only the third exists in any complexity. On the water, all three interact, and a weakness in any one of them stalls the other two.
Waterfront home construction South Florida rules are mapped in waterfront home construction in South Florida, and the technical detail in engineering challenges for Intracoastal and oceanfront homes.
What has to be verified before the lot is purchased?
Verify six items before buying a South Florida waterfront lot: the seawall’s age, cap condition, and tie-backs; the flood zone and base flood elevation; dock rights, permitted structures, and water depth at mean low tide; bridge clearance to open water; exposure, wake traffic, and orientation; and whether the parcel sits seaward of the Coastal Construction Control Line. These six decide most of what the project will cost.
Waterfront home construction South Florida budgets turn on flood rules, detailed in flood zone requirements, the oceanfront question in the Coastal Construction Control Line explained, and waterway rules by FWC.
What does the structure require?
The structure of a South Florida waterfront home requires deep foundations matched to coastal soils and scour; a lowest floor elevated above base flood elevation plus local freeboard; a continuous load path with corrosion-protected connectors; impact-rated openings engineered for the site’s true pressures; and flood-damage-resistant materials anywhere below the flood line. In waterfront home construction South Florida engineers treat these as one system, not five upgrades.
The elevation strategy is in elevated foundation and coastal home design and the wind side in hurricane-resistant construction.
How should the shoreline and marine scope be handled?
Handle the shoreline and marine scope first, and as its own subproject: seawall condition decides whether the wall is repaired, capped, or replaced before the house begins; dock and lift design must match vessel, depth, and navigation rules; and both run through reviewers independent of the building department. Marine work sequenced late is the classic waterfront schedule failure.
Waterfront home construction South Florida projects live or die on the shoreline decision, framed in seawall versus elevated foundation, with execution in seawall construction and permitting.
Who reviews a waterfront project?
Local building and zoning for the house, county floodplain administration for elevation, the Florida DEP for submerged lands and oceanfront jurisdiction, the water management district for stormwater and environmental resources, and federal reviewers for structures in navigable waters. Five sets of comments, several running at once, which is why complete first submittals matter more here than anywhere.
Waterfront home construction South Florida approvals span several agencies; state programs are published by Florida DEP and district permitting by the South Florida Water Management District.
What drives the budget?
The budget for waterfront home construction in South Florida is driven by marine engineering and permits; seawall repair or replacement; deep foundations and elevated structure; corrosion-rated materials and hardware throughout; flood-compliant detailing; and site logistics including drainage, barge, or crane access. Every one is a design-stage decision, and every one costs multiples more when discovered during construction.
Waterfront home construction South Florida budget structure is in the luxury construction cost breakdown, and the shoreline share in seawall construction costs and ROI.
What timeline should an owner expect?

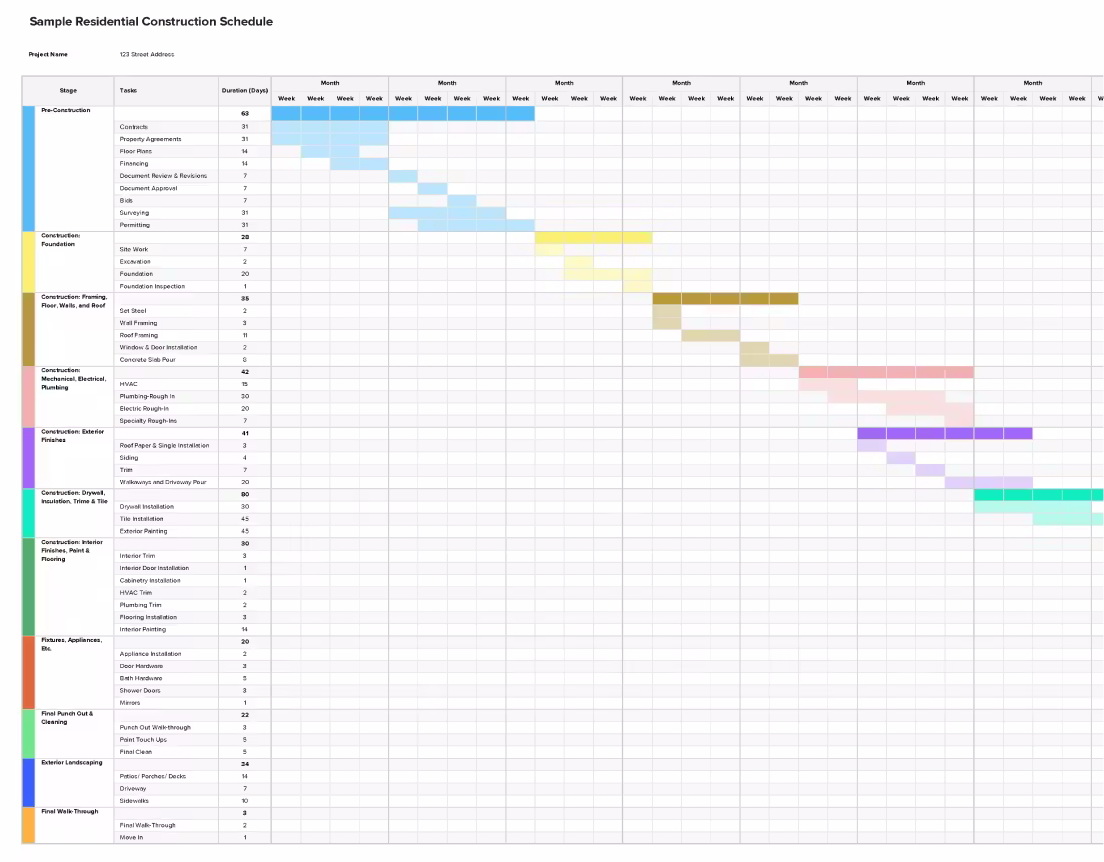

A South Florida waterfront custom build often runs 18 to 36 months, with the marine and environmental tracks frequently setting the start date rather than the house design. A high-end renovation often runs 6 to 12 months, and on the water it inherits the same shoreline questions. The schedule is protected by opening the slowest approval first and by submitting complete, coordinated packages.
Waterfront home construction South Florida schedules are protected by the discipline described in pre-construction planning.
How does Kass Construction & Development approach the waterfront?
By underwriting the site before the design: Kass Construction & Development, a state-licensed (CGC1529472) boutique luxury builder headquartered in East Fort Lauderdale and led by Mitch Kass, a licensed general contractor and attorney, with 100+ luxury residences delivered by Mitchell Kass and the firms he has led across Broward, Palm Beach, and Miami-Dade, resolves seawall, flood, dock, and approvals questions first, so the house is designed to a site whose limits are already known.
Contact Kass Construction & Development or call 954-607-4335.
What does the waterfront due-diligence checklist look like, line by line?
Waterfront home construction South Florida buyers get right starts with a written checklist that is closed before the purchase contract goes hard. The items below are the ones that change the design, the budget, or the feasibility of the project:
| Item | Source | What it decides |
|---|---|---|
| Flood zone and base flood elevation | FEMA flood map, local floodplain office | Finished floor height, foundation type, what may exist below the living level |
| Elevation certificate | Licensed surveyor | Insurance rating and the gap between existing and required elevation |
| Seawall condition, height, and ownership | Marine engineer inspection, title | Whether marine work precedes the house and who pays for it |
| Dock and lift rights, permit history | City and county records, state submerged-lands file | What can be rebuilt as of right versus re-permitted |
| Bridge clearance and water depth | Nautical charts, local knowledge | Which vessel the property can actually keep |
| Zoning envelope and waterfront setbacks | Municipal zoning code | Buildable footprint, height, and pool placement |
| Coastal Construction Control Line position | State survey of the line | Whether the state reviews the project (oceanfront parcels) |
| Geotechnical report | Soil borings | Pile versus spread foundations, dewatering needs |
| Open permits and code cases | Municipal permit search | Liabilities that transfer with the deed |
The map lookup itself takes minutes on the FEMA Flood Map Service Center; interpreting it for a luxury program is the subject of AE, VE, and X flood zones in Broward County and FEMA elevation certificates.
Which agencies review waterfront home construction in South Florida, and in what order?
A waterfront project in Broward, Palm Beach, or Miami-Dade passes through as many as six reviewers, and the slowest ones have to be opened first.
- Florida Department of Environmental Protection for environmental resource permits and, on oceanfront parcels, Coastal Construction Control Line review; also the state’s submerged-lands authorization for docks and seawalls.
- U.S. Army Corps of Engineers where work touches navigable waters or wetlands.
- South Florida Water Management District for surface-water and drainage permits on larger sites.
- County environmental and floodplain offices (for example Broward County’s environmental permitting for shoreline work).
- Municipal zoning and building departments for the vertical construction permit and floodplain compliance.
- Homeowners or architectural review boards where the parcel sits in a reviewed community.
The state and federal tracks run on their own calendars and frequently set the start date, which is why they belong in week one, the sequencing argument made in expediting CCCL, seawall, and flood zone permits and the permitting process for new seawalls.
How does the structure of a South Florida waterfront home differ from an inland build?
Waterfront home construction South Florida engineers design is a continuous load path from roof to pile, sized for wind, surge, scour, and salt.
- Foundations. Driven piles or augered piers through fill and high groundwater, with grade beams and an elevated slab or framed floor; basements are not an option.
- Elevated living level. Set at or above base flood elevation plus local freeboard; enclosures below are limited to parking, storage, and access with flood vents or breakaway walls.
- Wind design. Broward and Miami-Dade sit in the high-velocity hurricane zone, where the Florida Building Code requires product approvals tested to the region’s stricter standard for every opening; Palm Beach County follows the standard wind-borne debris provisions.
- Envelope. Impact-rated openings, sealed roof decks with secondary water barriers, and flashing detailed for wind-driven rain.
- Corrosion. Stainless or hot-dip galvanized connectors, marine-grade fixtures, and coatings rated for salt exposure throughout, per coastal corrosion-resistant materials.
- Mechanical placement. Air handlers, condensers, electrical panels, and generators above the design flood elevation.
The code text lives at the Florida Building Code; the county-by-county differences are summarized in building codes in Palm Beach, Broward, and Miami-Dade.
What are the most common mistakes in waterfront home construction, and how do you avoid them?
- Buying the view before the seawall. A failing wall can cost more than the renovation it was supposed to sit behind. Inspect before contract.
- Designing at grade and lifting later. Elevation should be composed from the first sketch, the argument of creative elevated design solutions.
- Opening the marine permits after the building permit. They are slower; open them first.
- Pricing by square foot. Marine scope, piles, and elevation are not in anyone’s rate.
- Under-budgeting time. A custom waterfront build often runs 18 to 36 months from design through closeout; general conditions run the whole way.
- Ignoring sea-level trend in cap heights and finished floors. Build in margin, as sea level rise in waterfront infrastructure design recommends.
Frequently Asked Questions
What should I know before building a waterfront home?
Verify the seawall, flood zone and base flood elevation, dock rights and water depth, bridge clearance, exposure, and whether the parcel is seaward of the Coastal Construction Control Line, all before closing. Those six facts shape the design and the budget.
How important is the seawall in waterfront home construction South Florida?
It is the most commonly underestimated item on a waterfront purchase. A failing wall is a large deferred cost, affects insurability and financing, and is far cheaper to replace before an estate stands behind it.
How many agencies review a waterfront project?
Typically four or five: municipal building and zoning, county floodplain, Florida DEP, the water management district, and federal reviewers for navigable waters. Oceanfront parcels add the state’s coastal line review.
Can I build the house first and the dock later?
You can, but it rarely helps: marine approvals run long, and doing them afterward means mobilizing equipment twice and living through a second construction period. Sequencing them together is usually cheaper and faster.
How much higher will my costs be than inland?
Site-specific, driven by marine engineering, seawall scope, foundation depth, elevation, and corrosion-rated specification. Real quantities from a builder who has done comparable waterfront work beat any per-square-foot rule of thumb.
What is the most common waterfront home construction South Florida mistake?
Designing before the site is understood. Nearly every expensive waterfront surprise, elevation changes, seawall replacement, dock redesign, traces back to drawings that started before the land was underwritten.
Do I need a builder with specific waterfront experience?
Yes. Marine sequencing, coastal soils, salt-rated specification, and multi-agency approvals are learned on waterfront projects and nowhere else. Verified local experience is the qualification that protects the schedule.
What is the biggest challenge in waterfront construction?
Foundation stability, flood compliance, and regulatory approvals.
How much more expensive is a waterfront home to build?
Typically 15%–30% more than inland homes.
What permits are required for waterfront construction?
- Building permits
- Environmental approvals
- Dock/seawall permits
